NASA’s race to save the Neil Gehrels Swift Observatory has entered a decisive phase after the rescue spacecraft built to lift the aging telescope into a safer orbit completed major environmental testing.
A Space Telescope Is Running Out Of Altitude
The Neil Gehrels Swift Observatory has been watching the high-energy universe since 2004, helping scientists track gamma-ray bursts, black holes, neutron stars, and other violent cosmic events that unfold far beyond Earth.
The spacecraft was designed as a fast-response observatory, able to rapidly turn toward sudden explosions in deep space and send data back to scientists while the events are still unfolding.
That capability has made Swift one of NASA’s most productive astrophysics missions, but the observatory now faces a problem it was never built to solve on its own.
Unlike many spacecraft, Swift has no onboard propulsion system capable of raising its orbit after years of gradual atmospheric drag.
Its altitude has dropped from roughly 600 kilometers to about 400 kilometers, a decline accelerated by elevated solar activity that has expanded Earth’s upper atmosphere and increased drag on satellites in low Earth orbit.
Without intervention, the observatory is expected to reenter Earth’s atmosphere later this year, ending the mission in a destructive plunge.
That risk has turned the telescope into the target of an unusually fast satellite servicing effort led by Katalyst Space Technologies, a company developing a spacecraft called Link to dock with Swift and push it higher.
The rescue attempt is not a routine extension of an existing mission; it is a rapid, high-pressure operation built around a spacecraft that must reach, attach to, and maneuver a decades-old observatory that was not launched with this kind of rescue in mind.

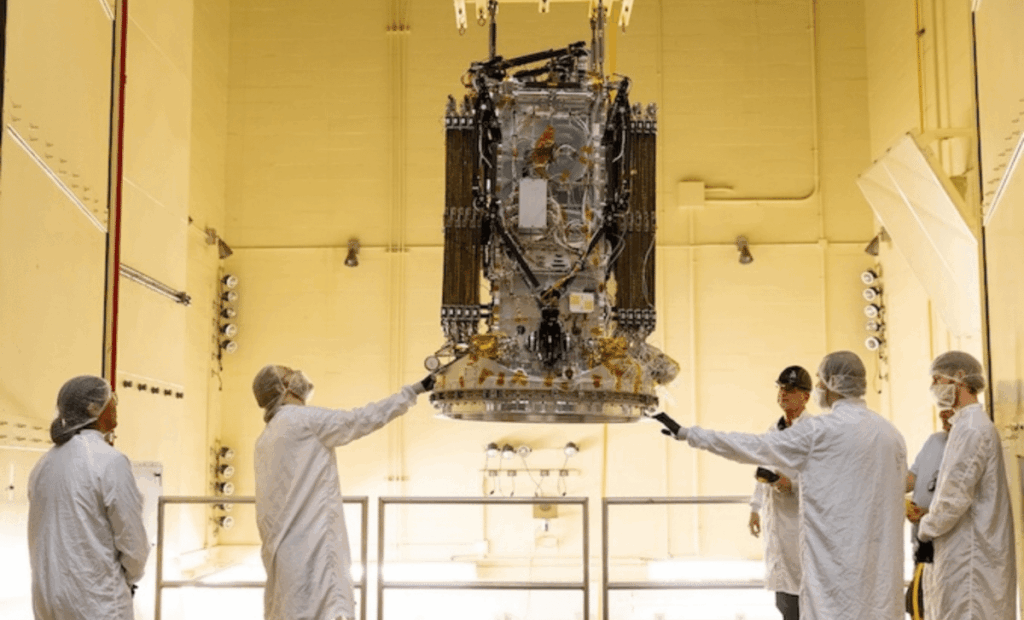

According to Space Flight Now, NASA announced that Link had completed environmental testing at the agency’s Goddard Space Flight Center in Greenbelt, Maryland, marking one of the final major hurdles before launch preparations move ahead.
The test campaign included work inside the Space Environment Simulator, where engineers exposed the spacecraft to conditions meant to validate its readiness for the vacuum and thermal stress of orbit.

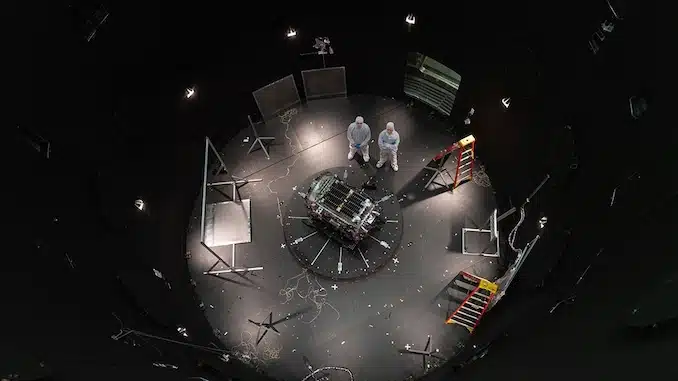

Kieran Wilson, Link’s principal investigator at Katalyst Space Technologies in Flagstaff, Ariz., and Hunter Robertson, a space systems engineer at Katalyst, stand next to their spacecraft inside the SES (Space Environment Simulator) at NASA’s Goddard Space Flight Center in Greenbelt, Md., on April 17, 2026, ahead of thermal vacuum testing. During testing in the SES, Link fired its three ion thrusters, deployed one of its three arms, and experienced space-like hot and cold temperatures.
Image: NASA/Sophia Roberts
Link Passes A Key Test At NASA Goddard
The completion of environmental testing is a significant step because Link is being prepared for a mission with little margin for delay.
Testing at NASA Goddard was designed to show that the spacecraft can survive the stresses it will face after launch and still perform the precise operations needed to approach and boost Swift.
After concluding testing in the Space Environment Simulator on May 4, the spacecraft returned to Katalyst Space Technologies facilities in Broomfield, Colorado, for additional prelaunch work.
The timeline is compressed because the target spacecraft is not waiting in a stable orbit; it is actively descending as drag continues to pull it closer to Earth.
That makes this mission different from standard satellite servicing demonstrations, where planners often have more flexibility to test, revise, and delay.
Here, every week matters because the observatory’s altitude is falling toward a point where rescue becomes harder, riskier, or no longer possible.
“The Swift boost attempt is a fast, high-risk, high-reward mission,” said John Van Eepoel, Swift’s mission director at NASA Goddard, in a NASA press release. “Swift will likely re-enter the atmosphere sometime later this year if we don’t attempt to lift it to a higher altitude. Katalyst has gotten to this point in just eight months, and we’re glad they were able to use NASA’s facilities to test Link and draw on our expertise to help tackle questions that popped up along the way.”
That statement captures the unusual balance NASA is trying to strike: move quickly enough to reach Swift before orbital decay wins, but test thoroughly enough to give the mission a credible chance of success.
The fact that Katalyst reached this stage in only eight months reflects how NASA is leaning on commercial spacecraft development methods to address a problem that traditional mission planning might not solve in time.
For an observatory with two decades of scientific legacy, the milestone keeps alive the possibility that Swift’s career could be extended rather than ended by atmospheric reentry.

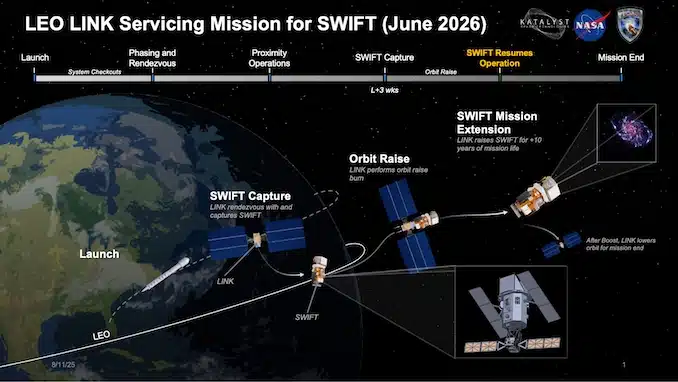

A graphical overview of the plan to extend the lift of NASA’s Swift observatory.
Graphic: Katalyst Space Technologies
NASA Is Betting On A Risk-Tolerant Rescue Strategy
NASA awarded Katalyst Space Technologies a $30 million contract in September 2025 to develop the rescue spacecraft, a relatively small sum compared with the estimated $500 million value of the observatory it is meant to preserve.
The logic behind the mission is direct: if Swift can be boosted into a higher orbit, NASA may keep using a proven astrophysics platform instead of replacing its capabilities with a new spacecraft, a process that would likely take years and cost far more.
The mission also carries broader implications for satellite servicing, because many valuable spacecraft were not designed for docking, refueling, or orbital rescue.
A successful boost of Swift would show that commercial servicing vehicles can be used on a wider class of aging satellites, including spacecraft that were launched before satellite life-extension became a practical commercial field.
NASA has described the attempt as an example of accepting more schedule and operational risk in exchange for a chance to preserve a valuable national asset.
“This is a forward-leaning, risk-tolerant approach for NASA. But attempting an orbit boost is both more affordable than replacing Swift’s capabilities with a new mission, and beneficial to the nation — expanding the use of satellite servicing to a new and broader class of spacecraft.”
The challenge is that Swift was not originally built with a propulsion-assisted rescue in mind, meaning Link must execute a technically demanding rendezvous and attachment operation under time pressure.
That pressure changes the decision-making process for engineers, who must weigh how much testing is enough when the spacecraft they are trying to save is moving steadily toward reentry.
“We’re in an unusual situation where the schedule dictates how much risk we’re willing to accept, rather than the other way around,” said Kieran Wilson, Link’s principal investigator at Katalyst. “The clock is ticking on Swift’s descent, so we have to find a balance between testing and problem solving that gives the mission the best chance of success.”
For NASA, that balance may become a model for future missions where speed matters as much as technical certainty, especially as more satellites in low Earth orbit face changing drag conditions linked to solar activity. For the commercial servicing industry, Link offers a high-profile test case: not just whether a private spacecraft can reach a NASA observatory, but whether it can do so quickly enough to matter.
Pegasus XL Was Chosen For A Difficult Orbit
The launch plan adds another unusual element to the rescue effort. Because Swift occupies an orbit inclined only 20.6 degrees from the equator, the mission needs a launch system capable of reaching a low-inclination orbit on a tight timeline.
That requirement led Katalyst to select Northrop Grumman’s Pegasus XL, an air-launched rocket carried beneath an L-1011 aircraft before being released at altitude.
Unlike a ground-launched rocket tied to a fixed launch site, Pegasus XL can be deployed from different locations, giving mission planners more flexibility to target specific orbital inclinations.
For this rescue attempt, that flexibility is central to the plan: Link is expected to integrate with Pegasus XL at NASA’s Wallops Flight Facility in Virginia early in the month, then be flown to the Marshall Islands for release later in the month.
Launching from that region helps the spacecraft reach the orbit needed to intercept Swift without wasting performance on a more difficult trajectory.
“The versatility offered by Pegasus’ unique air-launch capability provides customers with a space launch solution that can be rapidly deployed anywhere on Earth to reach any orbit,” said Kurt Eberly, Director of Space Launch for Northrop Grumman. “The stringent mission requirements necessary to save the Swift observatory, including the unique low-inclination orbit and the tight mission timeline, all pointed to Pegasus being the perfect choice.” The selection of Pegasus XL also shows how every part of the mission is being shaped by time and geometry.
The spacecraft must not only work; it must launch from the right place, into the right orbit, soon enough to catch an observatory that continues to lose altitude.
If the launch and rendezvous sequence succeeds, Link will attempt to dock with Swift and raise its orbit, buying the telescope more time for science and giving NASA a rare demonstration of rapid-response orbital servicing. If it fails or arrives too late, one of NASA’s long-serving astrophysics observatories could be lost to atmospheric reentry after more than two decades in space.
